Array ( [id] => 638695 [appid] => 1 [topicid] => 0 [galleryid] => 0 [channel_pc] => 1 [channel_wap] => 1 [channel_phone] => 1 [channel_pad] => 0 [title] => 10月开工!54个班!襄阳新建一中学! [editor] => 赵文丽 [has_thumb] => 1 [created] => 2025-09-21 11:00:58 [published] => 2025-09-21 11:00:58 [modified] => 0000-00-00 00:00:00 [digg] => 4 [pv] => 0 [comments] => 0 [shares] => 0 [recommend] => 0 [importance] => 0 [status] => 6 [enablecopyright] => 0 [sort] => 0 [origin] => 0 [syscomments] => 0 [main_category] => 789 [thirdparty_audit] => 0 [flow_step] => 0 [flow_id] => 0 [flow_index] => [gzh_account_id] => 0 [gzh_account_name] => [short_title] => [virtual_shares] => 0 [content] =>

9月19日

襄阳市公共资源交易网发布

襄阳市第十二中学新建项目

设计施工采购总承包(EPC)招标公告



襄阳市第十二中学新建项目设计施工采购总承包(EPC)招标公告

招标编号:XYSZ-JSGC202509FJ-063001001


项目概况


建设地点:位于襄阳市樊城区汉江路以东,建设路以南


建设规模:本项目拟建设54班规模的九年一贯制中学,其中初中18班,小学36班,容纳学生2520人。新建教学楼、综合楼、食堂、风雨操场、多功能厅、室外运动场、室外篮球场、地下室、非机动车停车场等。建设规模:该项目总建筑面积33605.40平方米,其中地上总建筑面积25282.26平方米(包括1#教学楼7777.33平方米,2#综合教学楼7466.98平方米,3#综合楼3380.68平方米,4#报告厅3174.31平方米,5#食堂、风雨操场3453.79平方米,门房29.17平方米),地下建筑面积8323.14平方米。


建设内容:1#教学楼、2#综合教学楼、3#综合楼、4#报告厅、5#食堂,风雨操场、门房、地下车库等新建主体工程,给排水、供电、室外场地及绿化等配套设施。



学校效果图


招标范围:初步设计批复内的全部满足业主功能需求内容的施工图设计,完成包含但不限于基坑支护设计、BIM设计、绿色建筑设计、人防设计、景观设计、海绵城市设计、安防设计、红线内外供配电设计(包括10kV电源接入点至红线内所有土建、电气等)、采购、施工、竣工验收、移交、保修服务等全部内容及招标和合同约定其他工作,并对承包工程的质量、安全、工期、造价全面负责。


计划总工期330日历天,其中设计工期60日历天,施工工期为270日历天,计划开工日期:2025年10月18日。

内容来源:襄阳市公共资源交易网

编辑:赵文丽|校对:李燕飞

审核:蔡彦燕


[subtitle] => [pagecount] => 1 [sourceurl] => [banner] => Array ( ) [description] => [thumb] => Array ( [url] => https://img.cjyun.org/a/10125/202509/acd9726c963509a63ce0a931d4c6b9eb.png [id] => 3677267 [ratio] => 0.43 ) [url] => http://xiangyang.cjyun.org/p/638695.html [wapurl] => http://m-xiangyang.cjyun.org/p/638695.html [attachments] => Array ( ) [relates] => Array ( ) [gallery] => Array ( ) [galleries] => Array ( ) [menu] => 0 [authors] => 赵文丽 [author] => 赵文丽 [terms] => Array ( [1] => [4] => Array ( [0] => 襄阳融媒体中心 ) ) [thumbs] => Array ( [0] => Array ( [url] => https://img.cjyun.org/a/10125/202509/acd9726c963509a63ce0a931d4c6b9eb.png [id] => 3677267 [ratio] => 0.43 ) ) [oldpv] => 968 [all_pv] => 0 ) 1

10月开工!54个班!襄阳新建一中学!

2025-09-21 11:00   襄阳融媒体中心

9月19日

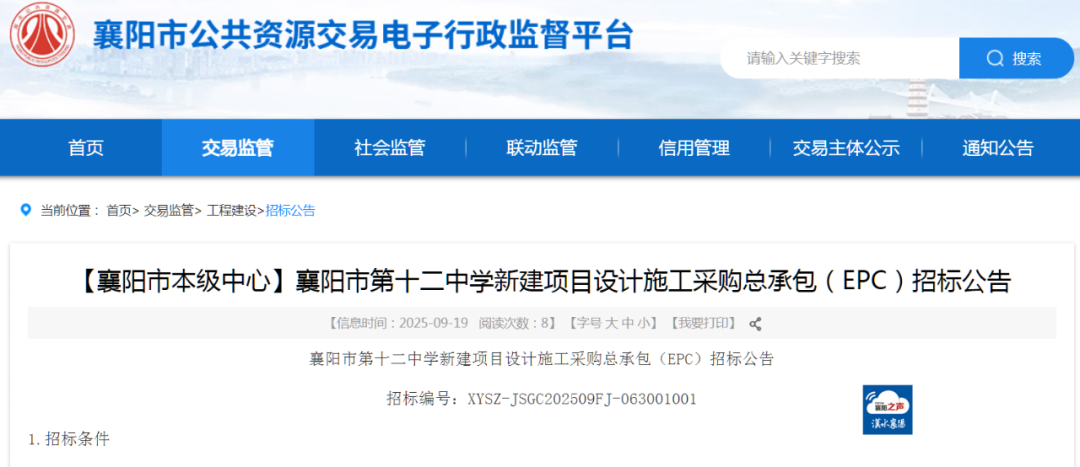

襄阳市公共资源交易网发布

襄阳市第十二中学新建项目

设计施工采购总承包(EPC)招标公告



襄阳市第十二中学新建项目设计施工采购总承包(EPC)招标公告

招标编号:XYSZ-JSGC202509FJ-063001001


项目概况


建设地点:位于襄阳市樊城区汉江路以东,建设路以南


建设规模:本项目拟建设54班规模的九年一贯制中学,其中初中18班,小学36班,容纳学生2520人。新建教学楼、综合楼、食堂、风雨操场、多功能厅、室外运动场、室外篮球场、地下室、非机动车停车场等。建设规模:该项目总建筑面积33605.40平方米,其中地上总建筑面积25282.26平方米(包括1#教学楼7777.33平方米,2#综合教学楼7466.98平方米,3#综合楼3380.68平方米,4#报告厅3174.31平方米,5#食堂、风雨操场3453.79平方米,门房29.17平方米),地下建筑面积8323.14平方米。


建设内容:1#教学楼、2#综合教学楼、3#综合楼、4#报告厅、5#食堂,风雨操场、门房、地下车库等新建主体工程,给排水、供电、室外场地及绿化等配套设施。



学校效果图


招标范围:初步设计批复内的全部满足业主功能需求内容的施工图设计,完成包含但不限于基坑支护设计、BIM设计、绿色建筑设计、人防设计、景观设计、海绵城市设计、安防设计、红线内外供配电设计(包括10kV电源接入点至红线内所有土建、电气等)、采购、施工、竣工验收、移交、保修服务等全部内容及招标和合同约定其他工作,并对承包工程的质量、安全、工期、造价全面负责。


计划总工期330日历天,其中设计工期60日历天,施工工期为270日历天,计划开工日期:2025年10月18日。
